Devonport Terrace Streetscape Upgrade

Document Library

Phase 1 consultation

ITP - Phase 1 consultation summary

ITP - Tonkins Engagement report - Phase 1 consultation

ITP – CoP Engagement report - Phase 1 consultation

Phase 2 consultation

ITP - March Council Meeting - Phase 2 Consultation Report

ITP - Fact Sheet: Overview

ITP - Fact Sheet: Draft road network plan

ITP - Fact Sheet: Draft cycling network plan

ITP - Fact Sheet: Draft walking network plan

ITP - Fact Sheet: Draft public transport plan

ITP - Fact Sheet: Draft parking management plan

ITP - Draft road network plan map

ITP - Draft cycling network plan map

ITP - Draft walking network plan map

ITP - Draft public transport plan map

ITP - Draft parking management plan map

Location

From Avenue Road up to the 1838 Development (just north of Gurr Street)

Construction Timeframe

May 2021- August 2021

Details of Project

The Devonport Terrace Streetscape Upgrade includes construction of new kerb and gutter in areas where it is required, garden beds with irrigation, and rain gardens to capture water runoff and improved pedestrian access around the station entrances with pram ramps.

Disruption to residents is expected to be minor, however due to the nature of the construction works, access through Devonport terrace will be limited and should be avoided where possible.

Devonport Tce 12 August 2021

Devonport Terrace Project Update - 13 June 2021

Works continue with the construction of stand-up kerbing adjacent the rail corridor, and excavation of the verge area for the construction of irrigated landscape garden beds. The state-wide lockdown for covid will delay the work program, but contractors will make every effort to minimise the delay and impact.

Works completed in previous period: (28 July – 11 August)

  • Completed kerbing from Avenue Road to Elizabeth Street
  • Continued Asphalt Reinstatement between Avenue Road and Elizabeth Street
  • Continued Excavation of Garden Beds from Avenue Road to Elizabeth Street
  • Commenced Construction of TreeNet inlets from Avenue Road to Elizabeth Street
  • Commenced Kerbing repair work between Elizabeth street and Pym Street
  • Commenced Kerbing construction between Pym street and the 1838 Development

Works Forecast for next period (12 August – 25 August)

  • Commence Irrigation construction between Avenue Road and Elizabeth Street
  • Continue Kerbing repair works between Elizabeth Street and Pym Street
  • Continue Kerbing Construction between Pym Street and the 1838 Development
  • Commence excavation for garden beds between Pym street and the 1838 Developments
  • Complete construction of the TreeNet inlets.

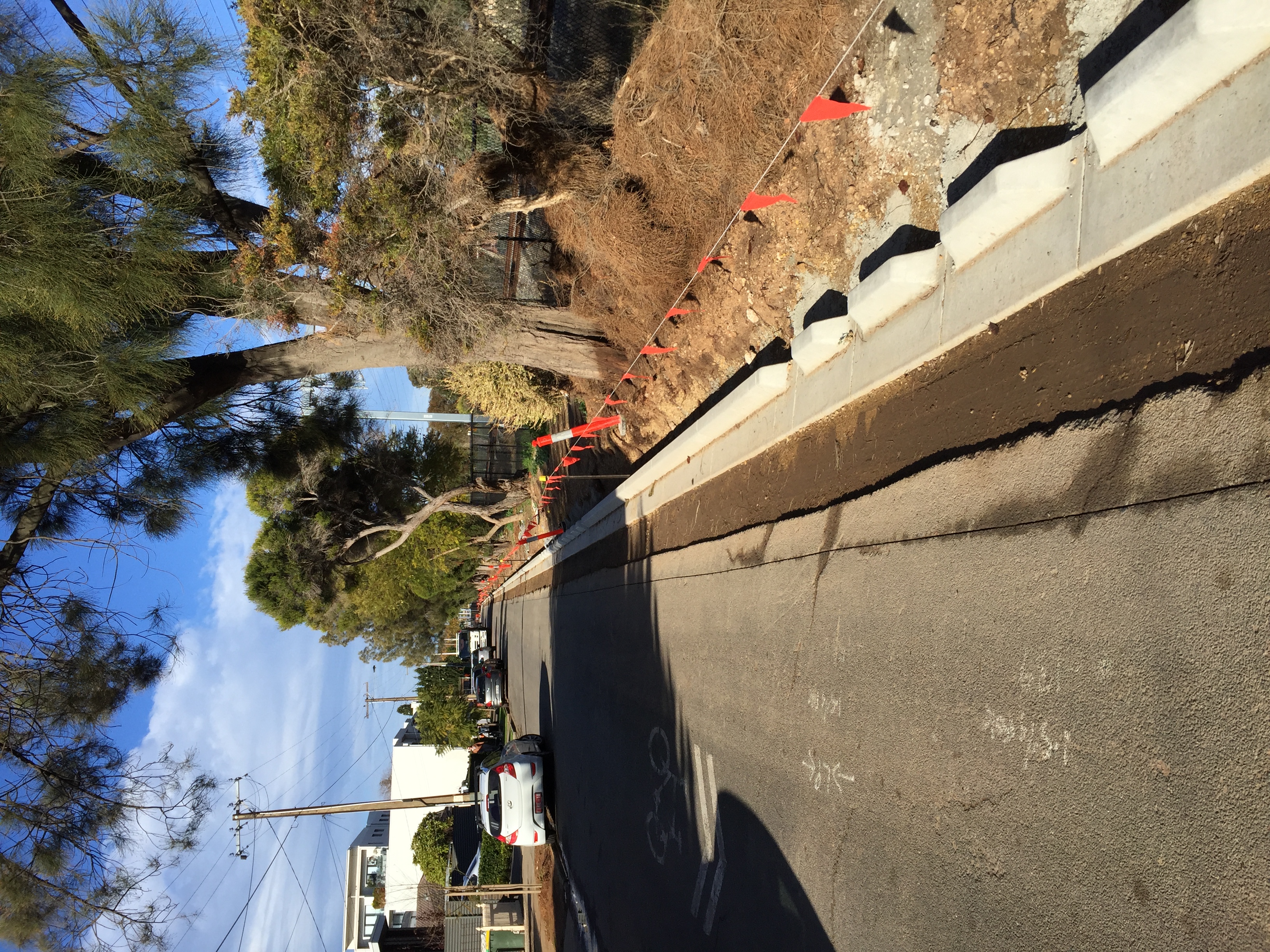

Devonport Terrace Progress Photo

Devonport Terrace Project Update - 28 July 2021

Works continue with the construction of stand-up kerbing adjacent the rail corridor, and excavation of the verge area for the construction of irrigated landscape garden beds.

Works completed in previous period: (29 June – 12 July)

  • Construction of stand-up kerbing between Allan Avenue and Avenue Road
  • Excavation of verge areas for the construction of landscaped garden beds between Elizabeth Street and Avenue Road
  • Saw cut road edge in preparation for asphalt

Forecast works planned for upcoming period: (13 July – 26 July)

  • Completion of final sections of kerbing between Elizabeth Street and Avenue Road
  • Continue excavation and preparation of Garden Beds between Elizabeth street and Avenue Road
  • Commence irrigation works between Elizabeth Street and Avenue Road
  • Asphalt reinstatement between Elizabeth Street and Avenue Road
  • Commence Garden Bed excavation and preparation between Belford Avenue and Pym Street.
